March 8, 2026
The expansion joint is widely recognised as the most maintenance-intensive component of a bridge deck. Studies of bridge maintenance records consistently show that failed or deteriorated expansion joints are among the leading causes of premature bridge deck deterioration, bearing damage, and substructure corrosion. Yet despite this well-established pattern, joint replacement is frequently deferred due to budget constraints or traffic management difficulties, allowing relatively minor joint failures to escalate into major structural problems.
This article provides a practical guide to the assessment, planning, and execution of bridge expansion joint replacement — one of the most impactful interventions available to bridge asset managers seeking to extend the service life of ageing highway and railway bridges.
Recognising Bridge Expansion Joint Failure
The signs of expansion joint failure are usually visible to a trained inspector. Concrete nosing deterioration: Cracking, spalling, and potholing of the concrete immediately adjacent to the joint gap is the most common and most visible sign of joint failure. It is caused by the combination of impact loading from vehicles crossing the joint and the ingress of water and de-icing salts through a failed seal. Once the nosing concrete begins to deteriorate, the rate of degradation accelerates rapidly.
Seal failure: A torn, displaced, or missing elastomeric seal allows unrestricted water ingress through the joint. Water staining and efflorescence on the bridge structure below the joint are clear indicators of this problem. Edge beam damage: Impact from vehicles — particularly heavy goods vehicles — can cause the steel edge beams to deform or fracture.
Bearing damage: Water passing through a failed joint will eventually reach the bridge bearings, causing corrosion of steel components and degradation of rubber elements.![]()
Advanced deterioration of a bridge expansion joint: the concrete nosing has completely failed, the elastomeric seal is missing, and extensive rust staining indicates long-term water ingress to the bridge structure below. This level of deterioration requires full joint replacement and structural repair of the pier cap below.
Assessment and Planning for Joint Replacement
Before specifying a replacement joint, a thorough assessment of the existing joint and the surrounding bridge structure is essential. This should include movement measurement — installing a displacement transducer across the joint and recording movements over at least one week to confirm the actual movement range; nosing concrete investigation — core samples to reveal the depth of deterioration and the condition of the reinforcement; and substructure inspection — checking the pier cap or abutment bearing shelf below the joint for water damage, corrosion, and structural cracking.
Selecting the Replacement Joint
The replacement joint should be selected based on the measured movement range, the traffic loading, and any lessons learned from the failure of the original joint. If the original joint failed due to inadequate movement capacity (a common finding on bridges where the original design underestimated thermal movements), the replacement joint must be specified with a larger movement range.
For bridges where the original joint was a simple rubber compression seal or a buried joint, upgrading to a strip seal or modular joint will typically provide a significant improvement in both performance and service life. The additional initial cost of the higher-specification joint is almost always justified by the reduction in maintenance costs and the extended replacement interval.![]()

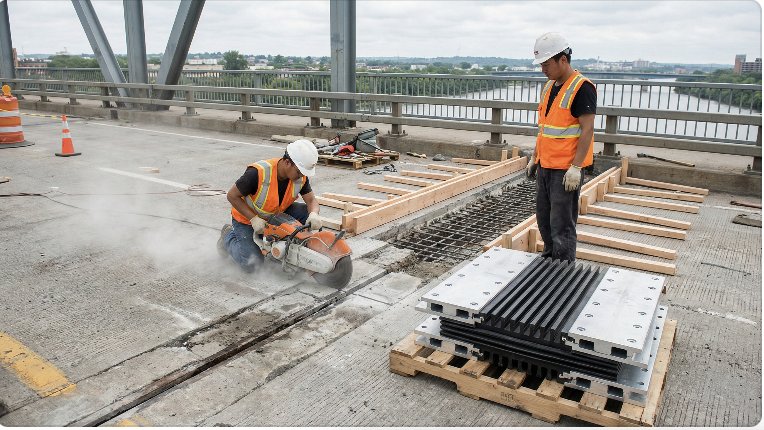

Bridge expansion joint rehabilitation in progress: the old failed joint has been removed, the concrete nosing is being prepared for the new joint, and a new modular expansion joint assembly is staged for installation. The use of rapid-hardening concrete for the nosing minimises traffic disruption.
Execution: Minimising Traffic Disruption
Joint replacement on a live bridge requires careful traffic management planning. The key constraint is the time required for the new nosing concrete to achieve sufficient strength before trafficking — typically 3–7 days for standard concrete, or as little as 4–8 hours for rapid-hardening concrete mixes. The use of rapid-hardening concrete is strongly recommended for joints on high-traffic routes where extended lane closures are not acceptable.
The work sequence is typically: traffic management setup → saw-cutting and breaking out old joint and nosing → reinforcement cleaning and repair → edge beam setting → nosing concrete placement → curing → seal installation → opening to traffic. For modular joints, the sequence is similar but with additional steps for the support bar installation and centre beam alignment.
Post-Replacement Inspection and Maintenance
After joint replacement, a structured inspection and maintenance programme should be established. The new joint should be inspected at 3 months, 12 months, and then annually. Early inspection is important to identify any installation defects before they develop into significant problems. The first seal replacement for a modular joint should be anticipated at 15–20 years, depending on traffic intensity and environmental conditions.
Bridgent provides a complete joint replacement service for ageing bridge structures, including joint supply across all movement ranges (0–1,200 mm), nosing concrete specification, installation supervision, and post-replacement inspection. Our experience covers highway bridges, motorway viaducts, railway bridges, and pedestrian structures in over 30 countries.
